CFO Seal in Gold

Agency Testing

Testing Timeline

Key dates associated with data conversion, interface testing, and user acceptance testing are included in the below Testing Timeline. Additional details about agency readiness tasks can be found in the Readiness Workplan.

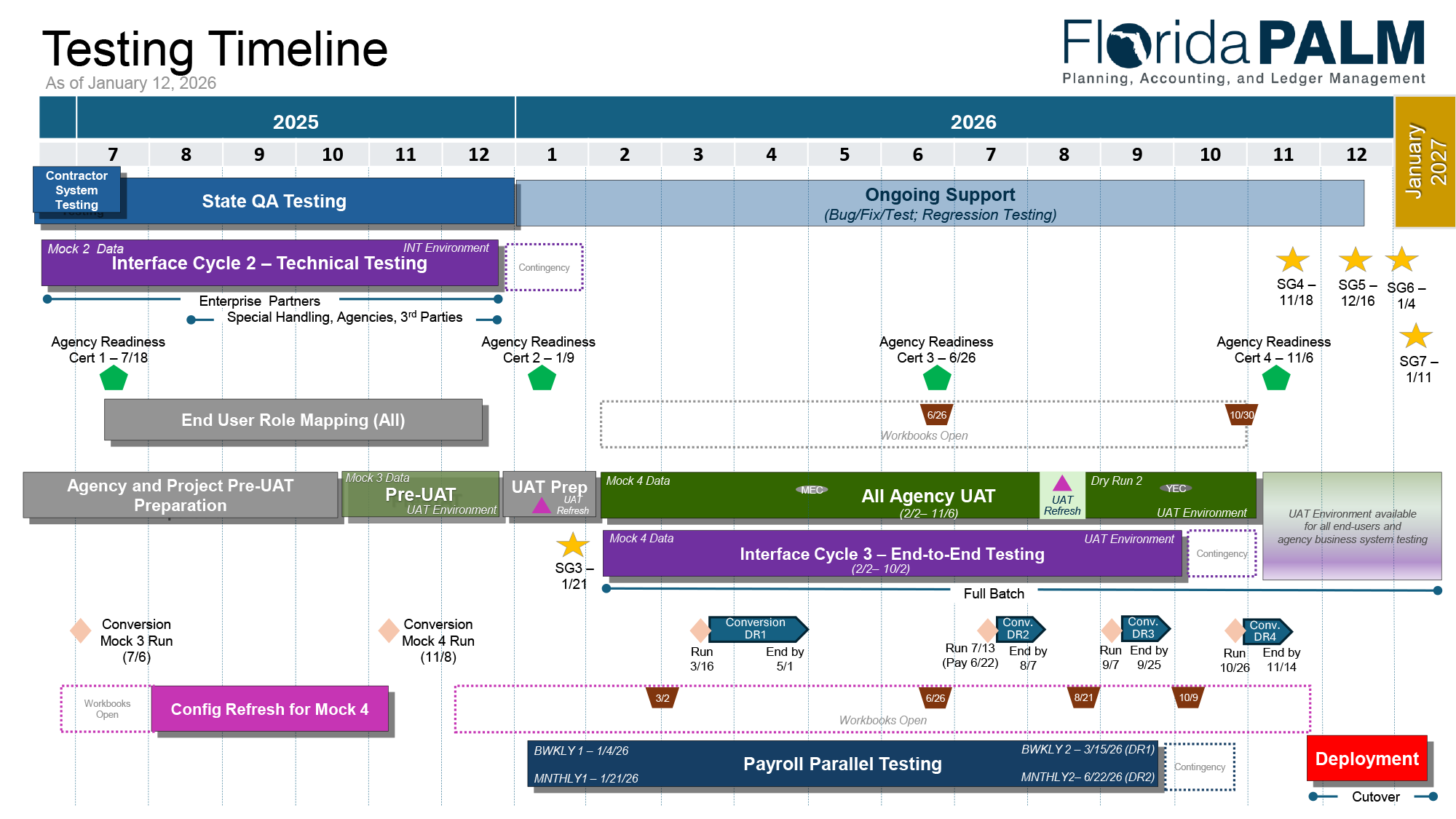

Click on the timeline graphic below to view an interactive testing timeline with information about each phase.

Interface Testing

What are interfaces? Interfaces refer to data exchanges between Florida PALM and external business systems. Florida PALM will interface with agency business systems, enterprise partners (e.g., MFMP, People First) and third parties (e.g., banks). Agencies are responsible for gaining an understanding of planned Florida PALM functionality, making decisions about how the agency will provide or consume Florida PALM information, and preparing agency business systems for interfacing with Florida PALM.

To support agency understanding, based on the completion of the design phase, the Project has provided a list of interface layouts through the Interface Catalog on the Knowledge Center. As the Project, enterprise partners, agencies, and third parties complete testing (e.g., system testing, interface testing, and user acceptance testing), additional changes may be made to interface layouts. The “As of Date” column on the Interface Catalog tables reflects either the original date of publication or the most recent date on which the layout was updated. Please check the Interface Catalog regularly for updates.

What options are there besides interfaces to extract data out of Florida PALM? Interfaces are one of several ways that information can be obtained from Florida PALM. The Data Availability Graphic illustrates where and how data will be available within the Florida PALM system, the Data Warehouse, and agency business systems. This graphic also describes where agencies may choose to receive information using standard interfaces from Florida PALM to maintain agency business systems that support those ongoing operations. Alternatively, agencies may request the Project create agency-unique data extracts from the Data Warehouse to support agency-unique needs for information not contained in the Project provided interfaces. These requests will be considered on a case-by-case basis. More information about the Reporting Solution and reports and reporting tools offered by Florida PALM and the Data Warehouse can be found in the Knowledge Center.

How many stages of interface testing are planned? There are three phases of testing planned for the Financials and Payroll implementation. Each is described below

Connectivity Testing

August 2024 - October 2024

Ensures interfacing partners can connect to the Florida PALM Managed File Transfer (MFT) Server to deliver inbound interface files and access outbound interface files.

Associated RW Tasks:

Technical Interface Testing

June 2025 - October 2025

Ensure inbound interface files from interfacing partner systems can be processed by Florida PALM; ensures outbound interface files from Florida PALM can be picked up and processed by interfacing partner systems.

Full Integration Testing

December 2025 - March 2026

During User Acceptance Testing (UAT) ensures that interfacing partners can complete all processes from start to finish, including those upstream and downstream processes that rely on interfacing system integration and interface data.


How can agencies learn more about interface testing?  An Interface Testing and Conversion workshop is planned for June 11, 2025. During the all-day event, the Project’s leadership, functional, and technical team members will provide information and discussion opportunities to support the understanding of agency data and business system readiness activities.  This workshop will provide information and discussion opportunities to support the understanding of agency data and business systems readiness activities. Greater details will be shared on:

  • Interface Testing, including the various cycles, the timeline for execution, the partner/participant expectations, and the implications (the “so what”) of the testing process
  • Conversion activities, including the various conversion cycles, the Project’s activities to lead and support the conversion process, and agency activities with regard to data review, clean up and usage

Agency Build and Unit Test

Agencies are currently completing their internal build and unit testing activities for their agency business systems based on their interface selection confirmation. A view of each agency's internal build and unit testing progress is now available. The Test Readiness Status button provides a snapshot of the current interface testing readiness by agency.

Agency Test Readiness Status

The reports below are real-time, live snapshot status of the agencies' readiness for Interface Cycle 2 – Technical Testing as reported by each agency for all interfaces and agency business systems. In addition to individual agency reports, the table includes a report for the status by interface and then agency, as well as the status by agency and agency business system.

If the view doesn't appear, refresh your browser or clear your cache.

User Acceptance Testing

As described in the UAT Approach, agencies will participate in UAT for 11 months through the following stages.

Project Hosted

UAT will begin with several months of Project-hosted sessions where agency-identified Subject Matter Experts (SMEs) will attend sessions based on business process. Sessions will be focused on manual entry in Florida PALM (i.e., online transactions). Upon completion of the Project-hosted sessions, agencies must facilitate testing for all agency end users.

Registration – Stay Tuned

Agency Led

Agency SMEs that participated in UAT Online will facilitate UAT Full with agency end users. Agencies will be able to test their business processes, start to finish, with their own data (Mock 4 data), including their selected interfaces with their agency business systems and enterprise partners. Agencies will create their unique UAT training materials to support their agency-led sessions. Registration will be organized through agency communications.


What to Expect

Registration for UAT Online will be available on the Florida PALM website. Sessions will be grouped by business process and role. Space is limited so be sure to identify the correct SME. Sessions will be held weekly, and topics will not repeat. These sessions will include guided system navigation and the functions performed in the  Topics and Activities listing.

Included in UAT Online

  • Processing transactions online
  • Online batch processing and Data Warehouse batch processing
  • Processing spreadsheet uploads
  • Processing reports in Florida PALM and the Florida PALM Data Warehouse
  • Creating new Queries in the Florida PALM Data Warehouse
  • Off-cycle payroll processes (e.g., cancellations, adjustments)

Not Included in UAT Online

  • Interface testing – this will occur in a separate interface testing environment
  • Interface batch processing
  • Payroll Processing (i.e., biweekly, monthly, supplemental) – this will occur in the interface testing environment and in the parallel testing environments

Included in UAT Full

  • Processing transactions online
  • Processing spreadsheet uploads
  • Interface processing
  • Full batch schedule
  • Processing reports in Florida PALM and the Florida PALM Data Warehouse
  • Creating new Queries in the Data Warehouse
  • Interface batch processing
  • Full Payroll Processing

Not Included in UAT Full

  • NA

How to Prepare

Agencies have a role in UAT preparation. Before participating in UAT, agencies should prepare by planning for, or completing, the following:

  • Review or complete your change analysis inventory (RW Task 560) to understand the changes in business processes or systems that need testing and validating during testing
  • Create User Stories to support user testing (RW Task 574)
  • Gathering of agency data and documentation (e.g., applicable COA values, source documents to support work simulation)
  • Coordination / assignment of agency participants (RW Task 573-A, 573-B)
  • Prepare for UAT Full sessions (logistics, materials, etc.)

Coming soon!
